Vizsla Silver Advances Panuco Toward Construction with Latest Equipment Award

Vizsla Silver advances Panuco toward construction with a key equipment award, reinforcing budget discipline, execution readiness, and project timelines.
- Vizsla Silver has awarded an equipment supply agreement to FLSmidth (FLS), covering 8 major process plant packages across the full proposed flowsheet for the Panuco silver-gold project in Sinaloa, Mexico.
- The award converts vendor quotations into a binding supply relationship, removing the process plant as a scheduling variable ahead of the Second Half of 2026 construction decision.
- Equipment is specified for a Phase 1 throughput of 3,300 tonnes per day, with a planned Phase 2 expansion to 4,000 tonnes per day, and the contract is structured to accommodate integration of the Napoleon mine in Year 4.
- The November 2025 Feasibility Study (FS) returned an after-tax net present value at a 5% discount rate (NPV5%) of US$1.8 billion and an internal rate of return (IRR) of 111%, with initial capital expenditure (capex) of US$238.7 million fully covered by total financing capacity of US$457 million.
- A construction decision is targeted for the Second Half of 2026, with first silver production targeting the Second Half of 2027.
The Construction Decision Clock Is Ticking

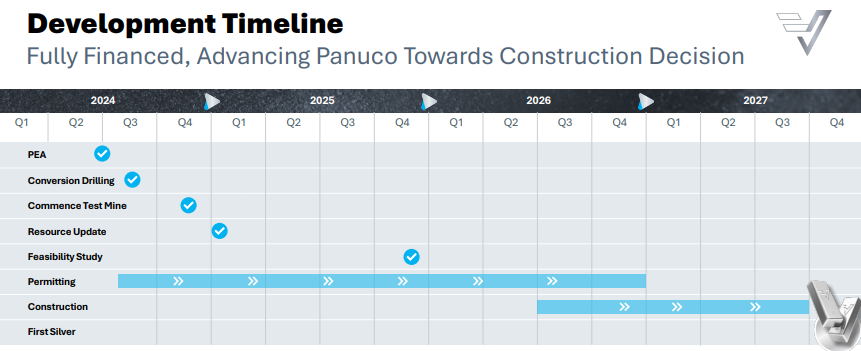

For investors tracking Vizsla Silver Corp. (TSX: VZLA | NYSE: VZLA | FRA: 0G31) and its Panuco silver-gold project, the equipment supply agreement awarded to FLSmidth (FLS) on June 16, 2026, matters less as a procurement headline and more as a signal of sequencing. A construction decision targeted for the Second Half of 2026 is now roughly 1 to 6 months away. What the FLS contract does is eliminate one of the last remaining variables that could have delayed it.

Junior and mid-tier mining companies lose credibility with investors when timelines slip between the publication of a feasibility study (FS) and the construction decision. The gap is where cost estimates drift, long-lead items create scheduling uncertainty, and the market discounts the probability of execution. Vizsla Silver has moved to close that gap: 7 months after the November 2025 FS was published, the company has a binding equipment supply agreement covering 8 major process plant packages across the complete proposed flowsheet.
Budget Discipline Is the Real Signal
The process plant represents US$63.9 million of the US$238.7 million initial capex outlined in the 2025 FS. Confirming that the FLS package remains aligned with the process plant capital budget outlined in the Feasibility Study is not a mere formality. It is the first external confirmation that a major contract has been priced without requiring a budget revision.
Chief Operating Officer of Vizsla Silver, Simon Cmrlec, was direct about what the agreement delivers on multiple fronts:
"We are pleased to be working with the FLS team, who has provided us with a technically robust equipment package for the Project which supports both the initial Phase 1 plant design and future Phase 2 expansion plans while remaining in line with the process plant capital budget outlined in the Feasibility Study. FLS's Life-Cycle Service Offering will provide us with a high level of support throughout the commissioning, ramp-up and operations phases of the Panuco facility."
That budget discipline matters because the FS was already built on a high-confidence cost base. More than 90% of direct costs were underpinned by vendor quotations rather than factored estimates, a standard that compresses the range of outcomes between study and execution. The FLS contract price holding within that envelope further narrows the cost risk profile, which is directly relevant to investors assessing whether the initial capex figure is defensible at the point of the construction decision.
Engineering for the Full Mine Life, Not Just Start-Up
The contract scope also reveals something about how the team is approaching execution risk. Equipment has been specified to support not only the Phase 1 throughput of 3,300 tonnes per day but also the Phase 2 expansion to 4,000 tonnes per day, and the contract is structured to facilitate Napoleon mine integration in Year 4 with minimal operational downtime, representing engineering decisions made for the full 9.4-year mine life rather than a start-up configuration alone.
FLS is well-suited to that scope. The company supports mining operations in more than 125 countries, has a service centre in Zacatecas, Mexico, and provides a Life-Cycle Service Offering that spans commissioning, ramp-up, and operations. For a greenfield silver processing facility, a vendor with that level of in-country support capability reduces the execution risk at the stages where new operations are most vulnerable.
Products Business Line President at FLS, Qasim Abrahams, described the scope of the relationship:
"We are excited to be selected as Vizsla Silver's key technology partner for their complete silver processing flowsheet. With our leading technologies and life-cycle service offerings, we look forward to helping Vizsla Silver maximise silver recovery and production throughout the life cycle of this new operation."
The Economics That Make the Timeline Worth Watching
The case for watching that timeline closely begins with the project behind it. The November 2025 FS returned an after-tax net present value at a 5% discount rate (NPV5%) of US$1.8 billion against an initial capex of US$238.7 million, a ratio of 7.5x. The after-tax internal rate of return (IRR) is 111%, with a 7-month payback at base-case silver and gold prices. Life-of-mine average all-in sustaining cost (AISC) is US$10.61 per ounce of silver equivalent, with average annual payable production of 20.1 million ounces silver equivalent in Years 1 through 5 and 17.4 million ounces silver equivalent over the full mine life at a head grade of 425 grams per tonne silver equivalent.

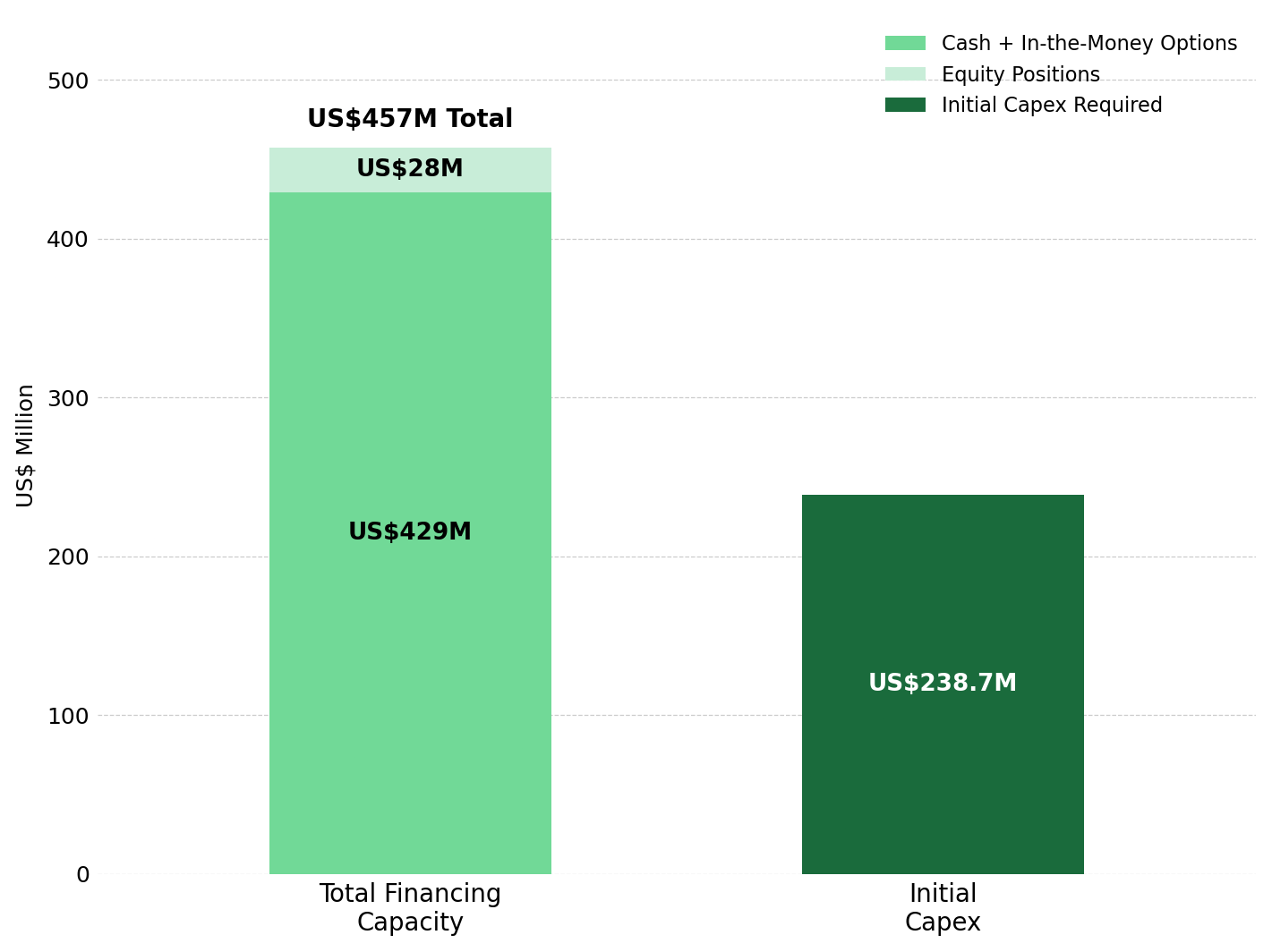

Financing is not a gating issue. Per the March 2026 MD&A, total financing capacity stands at US$457 million, comprising US$429 million in cash plus in-the-money options and US$28 million in equity positions. That covers initial capex of US$238.7 million, with material headroom, underpinned by a US$300 million capped call convertible notes offering, completed in late 2025, with a 5% annual coupon and a January 2031 maturity.

What Investors Should Watch From Here
With equipment supply contracted, the open items ahead of the Second Half of 2026 construction decision are permitting completion and the formal notice to proceed that will authorise FLS to begin manufacturing. The company anticipates that notice in the coming months.
First silver production is targeting the Second Half of 2027. Less than 28% of known vein targets at Panuco have been drill-tested to date, per the May 2026 corporate presentation, and Napoleon mine integration in Year 4, already engineered into the FLS contract, is the most visible near-term mechanism for production growth beyond the Phase 1 configuration.
The FLS award does not guarantee a construction decision. What it does establish is that a major procurement commitment has been made on time and within the capital budget outlined in the 2025 FS, 7 months after the study was published.
