West Red Lake Gold Mines' Operational Mechanics: De-Risking the Madsen Ramp-Up

West Red Lake Gold de-risks the Madsen ramp-up through positive cash generation, operational flexibility, and a growing pipeline of future mining fronts.
- West Red Lake Gold Mines generated US$41.8 million in revenue and US$15.3 million in mine operating income during the first quarter of 2026, achieving a 37% operating margin and reporting adjusted earnings before interest, taxes, depreciation, and amortisation of US$14.4 million.
- The company maintained 2026 production guidance of 35,000 to 45,000 ounces, with approximately 60% of output expected in the second half of the year as additional mining areas enter production.
- Access to the 4447 complex was rescheduled to the second quarter of 2026 to prioritise development progress and long-term mine flexibility.
- West Red Lake Gold Mines is advancing multiple future mining fronts, including the 960, 904, Fork, and Derlak areas, to support production growth and operational flexibility through 2027.
- A 6,300-metre drill program increased Rowan's indicated gold resource by 70% to 334,000 ounces and inferred gold resource by 52% to 179,000 ounces, while Mount Jamie added an initial resource of 84,000 ounces ahead of the updated Madsen-Rowan pre-feasibility study expected in the third quarter of 2026.
What Has Happened
West Red Lake Gold Mines (TSXV: WRLG | OTCQX: WRLGF) reported first-quarter 2026 revenue of US$41.8 million and mine operating income of US$15.3 million from the sale of 6,165 ounces of gold, generating a 37% operating margin. The company reported earnings before interest, taxes, depreciation, and amortisation (EBITDA) of US$3.3 million, adjusted EBITDA of US$14.4 million, and approximately US$35.9 million in cash after beginning debt repayments. Development focused on the South Austin and 4447 mining areas, while Rowan and Mount Jamie resource updates advanced the upcoming Madsen-Rowan pre-feasibility study (PFS).
Re-Sequencing the 4447 Complex for Long-Term Mine Flexibility
During the first quarter of 2026, mining activities focused on sill development in the South Austin area and the 4447 complex. Access to 4447 was shifted into the second quarter as part of a strategy prioritising development advancement and long-term mine flexibility. The company maintained full-year production guidance of 35,000 to 45,000 ounces, with approximately 60% of output expected in the second half of 2026 as additional mining areas enter production.
Advancing Non-Remnant Development Fronts

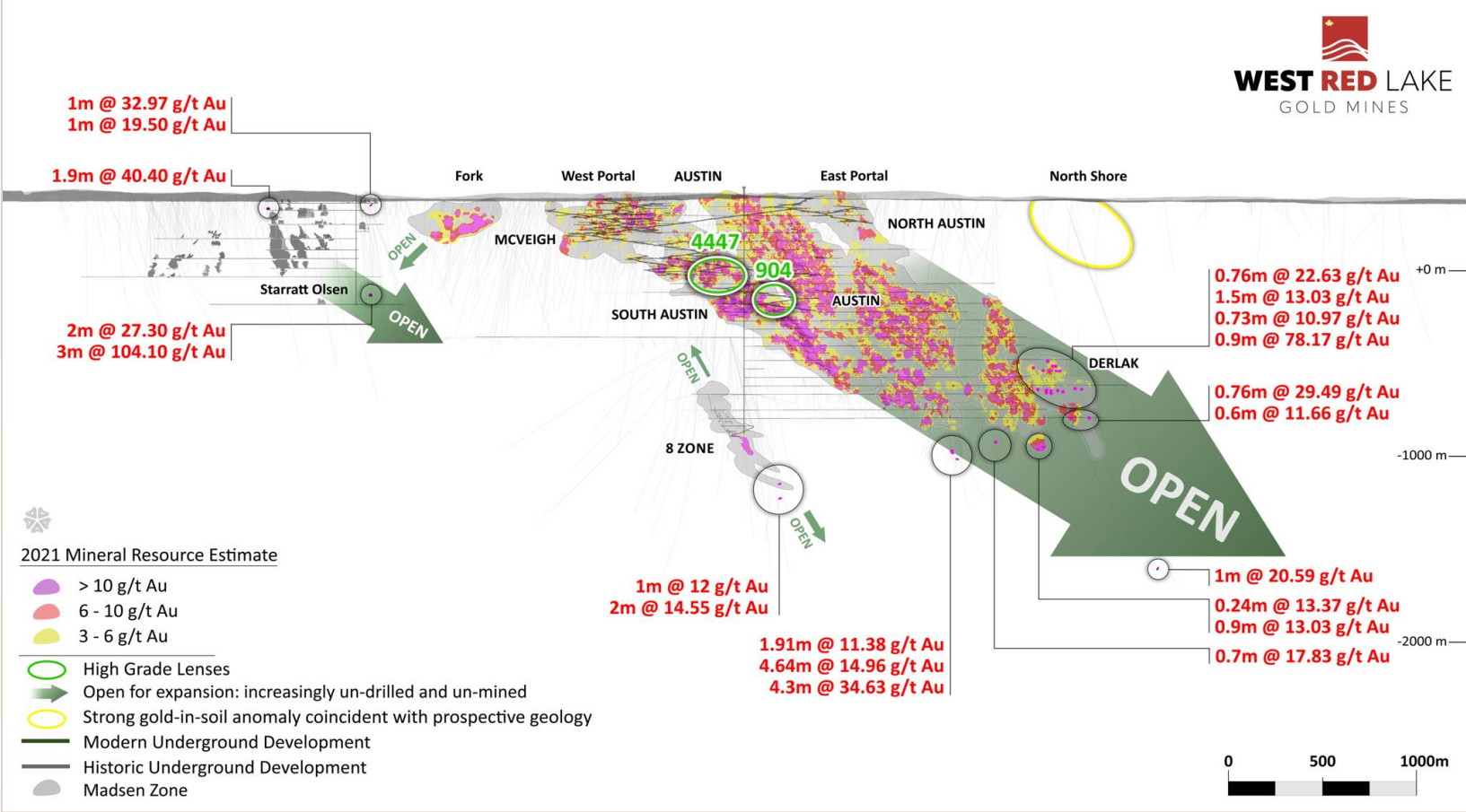

West Red Lake Gold Mines is advancing multiple non-remnant mining areas to support production growth through 2027. The 960 and 4447 complexes are targeted for active mining in the first and second halves of 2026, respectively, while the largely unmined 904 complex is expected to enter production in the first half of 2027. The nearby Fork satellite deposit, located approximately 250 metres from existing Madsen infrastructure, is targeted for development in the second half of 2026 and production in the first half of 2027, supported by resources of 20,900 indicated ounces and 49,500 inferred ounces at an average grade of 5.2 grams per tonne, plus a high-grade core target of 33,000 to 43,000 ounces grading 8 to 9 grams per tonne. Development of the eastern connection drift toward the Derlak complex is also progressing, adding another future mining front.
Advancing the Post-Commercial Ramp-Up with Positive EBITDA
Financial results during the first quarter of 2026 reflected the early-stage nature of the ramp-up phase, while demonstrating the operation's capacity to generate positive cash flow. West Red Lake Gold Mines reported US$41.8 million in revenue, US$15.3 million in mine operating income, EBITDA of US$3.3 million, adjusted EBITDA of US$14.4 million, and approximately US$35.9 million in cash after beginning debt repayments. The company maintained production guidance of 35,000 to 45,000 ounces for 2026, with approximately 60% of output expected in the second half of the year.

Figure 1. Strategic Advantage showing the full-year 2025 and first-quarter 2026 production and revenue table. Source. June 2026 Corporate Presentation.
What to Watch Next
Key milestones over the next 18 months include the 904 complex entering production in the first half of 2027; the Fork satellite deposit beginning development in the second half of 2026 and entering production in the first half of 2027; and the completion of the Phase 1 shaft refurbishment in the second half of 2026. At Rowan, a 6,300 metre drill program increased the indicated gold resource by 70% to 334,000 ounces grading 13 grams per tonne and the inferred resource by 52% to 179,000 ounces grading 15.3 grams per tonne. An initial resource was also established at the nearby Mount Jamie deposit, totalling 49,000 ounces indicated and 35,000 ounces inferred. Both deposits will be incorporated into an updated Madsen-Rowan pre-feasibility study expected in the third quarter of 2026.
Vice President of Exploration of West Red Lake Gold Mines, Will Robinson, highlighted the longer-term potential of the two deposits:
"If and when we do move forward with an extraction scenario at Rowan, the hope is that we can start building out Mount Jamie and growing that resource, and then have two separate satellite areas for mining simultaneously."
